Windsor Siding master plan

  • Project typeMaster plan implementation

In September 2015, Council adopted the Windsor Siding Reserve master plan that will introduce new and improved facilities at this popular Windsor park.

Implementation of the master plan was planned in six stages with construction budgeted over several financial years.

The first stage of construction started in mid-2016 and subsequent stages have been rolled out progressively since then.  It is anticipated all stages of the master plan implementation will be completed the end of 2025.


Master plan implementation

Upcoming works

Project

Stage 4 - Windsor Train Station connection

The final stage of the master plan implementation will deliver a safe, accessible and attractive pathway connection between the park and train station, with:

  • Disability Discrimination Act 1992 compliant pathway
  • Improved sight lines to and from the park
  • New lighting to provide a well-lit pathway for night time commuters
  • New seating to encourage use of the area and passive surveillance
  • Landscaping - noting existing vegetation will be retained where possible.

These works will be delivered in two stages:

Stage 4A - from April 2025 - path construction from within Windsor Siding Park and into Victorian Government land.

Stage 4B - TBA - path will extend to Peel Street where it connects to Windsor Station.

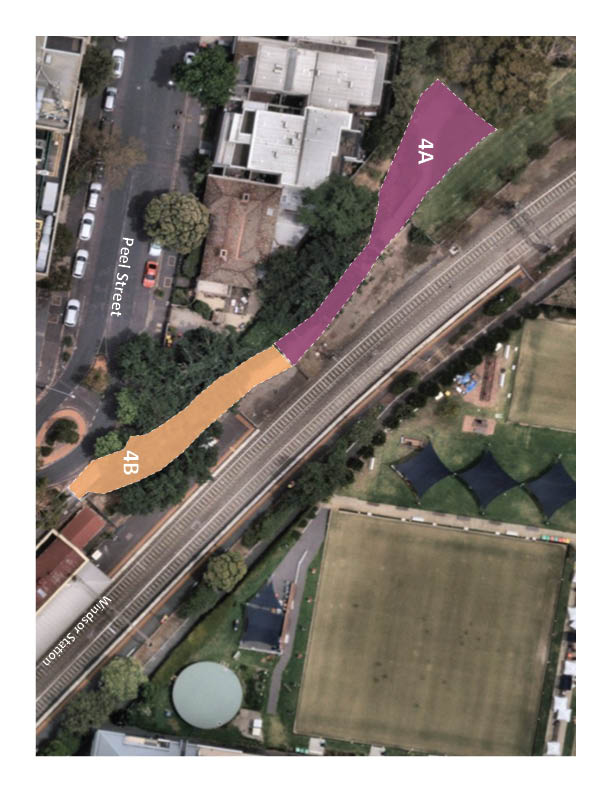

Windsor Siding 4a&4b.jpg

Construction timeline

April to July 2025
Hours of work  7am to 4pm (Monday to Friday)
Scope of work
(Stage 4A)

Remove existing retaining wall and bridge

Construct storm trap structure for stormwater retention

Construct brick clad retaining wall

Construct accessible concrete pedestrian path

Landscaping works

Install new lighting

Contact

Contractor

Richard Jordan
M: 0412 248 096


City of Stonnington

Project Manager
James McNeur
P: 8290 1333


Emergency (24 hours)

P: 8290 1333



 About the project

Why are we doing these works?

This is the fourth and final stage of the Windsor Siding masterplan works. Council adopted the masterplan in 2015, and we have been progressively delivering projects in the plan since then. At the completion of the drainage and path extension works, the masterplan will be fully delivered.

The principal reason for these works is for flood mitigation by improving and increasing catchment capacity of the stormwater drainage system, and to improve pedestrian access to and from Windsor Train Station by replacing the existing path with a DDA (Disability Discrimination Act) compliant path with lighting.

The connection will also make it possible for the Victorian Government to build a compliant second entrance and access point into Windsor Train Station directly from Windsor Siding Park.


What is the scope of works?

The works to be undertaken include:

Upgrading the existing pathway to an accessible sealed pathway

Lighting

Improving drainage to increase water capacity to mitigate flood risk.


What is the extent of the works?

The Stage 4A works extends from Windsor Siding Park, just east of the existing small bridge, to the eastern extent of the existing train station platform.


Why are we not upgrading the entire path from Peel Street to Windsor Siding Park at the same time?

The original plan was to complete all works at once however the Department of Transport has indicated they plan to build a new second entrance to Windsor Train Station, with the access point connecting to Windsor Siding Park.

The Department of Transport design has not been finalised. The final design may make any works we do now redundant, so the decision has been made to hold off until we know the Department’s final design plan.


Who owns this parcel of land?

The land within the extent of the planned path and drainage works is owned by the Department of Transport. The City of Stonnington leases the land for the purpose of providing public access and amenity to and from Windsor Siding Park.


Has community engagement been completed for the path and/or drainage design?

No. Community engagement on the design has not been completed for this project as design approval sits with the Victorian Government and community influence is limited.


How long will the works take?

We are currently in the process of appointing a contractor to complete the construction. Once this has been finalised the we will advise the construction timeline.


Will it be possible to access Windsor Station via Windsor Siding Park during the works?

No, access to the station from Windsor Siding Park will be closed for the duration of the works.

Windsor Station can be accessed from the south-western entrance/exit to Peel Street, and we will install signs at locations around the park directing pedestrians to the station.


Will any trees be removed as part of the works?

No.

Concept Plan View Windsor Station connection concept plan(PDF, 2MB)

Completed works

 Project  BMX track upgrade
 Status  Completed December 2023
 Scope of works

Demolish existing BMX track

Reconfigure BMX track

Build new track (reddish brown asphalt)

New garden beds and landscaping

Tree planting


Project  Stage 6 construction
Status  Completed mid-2020
Scope of works

Remove existing playground

Install new play equipment including nature play elements

New fence

New garden beds and additional tree planting


Project
Stage 5 construction
Status  Completed mid-2019
Scope of works

Extended lawn area

Path connection to Union Street

New lighting

New park furniture and seating

Native trees and garden bed planting

New barbecue

New boom gate


Project   Stage 3 construction
Status   Completed early-2019
Scope of works

Extended lawn area

New concrete path connection to Peel Street

New pedestrian lighting

New garden beds and tree planting

Park furniture


Project   Stage 2 construction
Status  Complete late-2017
Scope of works

New central picnic area

Shelter

Seating

Drinking fountain

Lighting

Barbecue

Improve path network


Project  Stage 1 construction
Status  Complete mid-2016
Scope of works

Construct east-west concrete path connecting to Windsor Train Station

Construct secondary path

Install pedestrian lighting

Construct lawn areas

New garden bed and tree planting

Construct battered slopes

Park furniture

Demolish and relocate BMX track

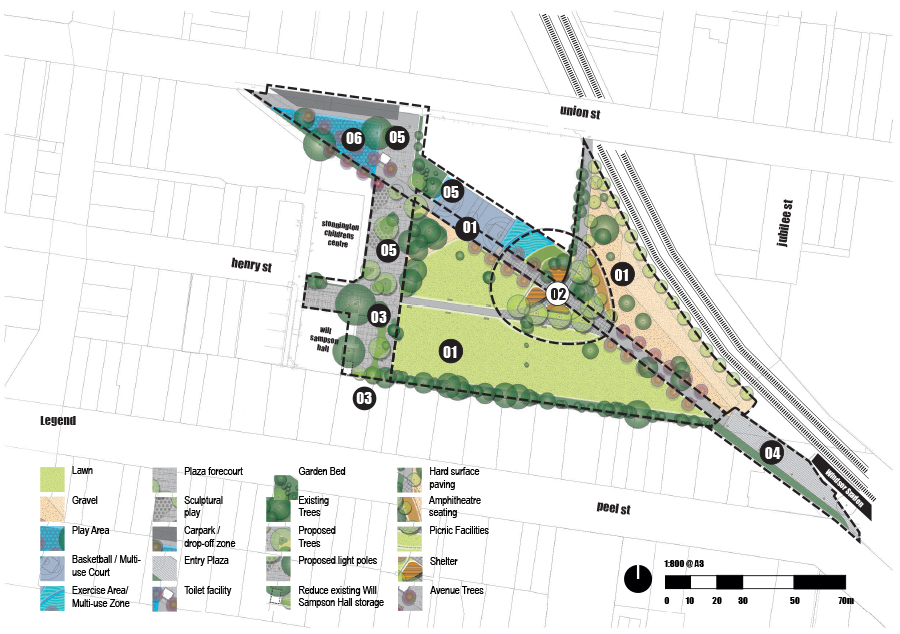

Staging plan

Download Windsor Siding master plan implementation stages(PDF, 1MB)

Stage  Deliverables Status
1 BMX track relocation - pathways - lighting - lawn areas - irrigation - garden beds - tree planting - park furniture Complete
New central picnic area - shelter - easing - drinking fountain - lighting - barbecue - path network. Complete
Expanded lawn area - path connection from Peel Street - lighting - garden beds - tree planting - park furniture   Complete
Windsor Train Station connection  Planned
Expanded lawn area - path connection to Union Street - lighting - park furniture - native trees - garden bed planting - barbecue  Complete
New playground - fencing - garden beds - tree planting  Complete



Timeline

Timeline

TBA  Stage 4B construction - Windsor Train Station connection
April 2025 Stage 4A construction - Windsor Train Station connection
December 2023 BMX track upgrade - construction complete
late-2022  BMX track upgrade - final design announced
August/September 2021  BMX track upgrade - consultation on draft design
June to late-2020  Stage 6 construction - new play equipment, garden beds, tree planting, fence, extended lawn, park furniture, seating.
October to December 2019  Stage 5 construction - extended lawn area, pathway connection to Union Street, lighting, park furniture, barbecue, trees and garden bed planting, boom gate.
late-2018 to January 2019 Stage 3 construction - extended lawn area, pathway connection Peel Street, lighting, garden beds, trees, park furniture
June 2018 Stage 3 concept design - community consultation
June to September 2017 Stage 2 construction - new central picnic area, shelter, seating, drinking fountain, lighting, barbecue, path improvements.
May to July 2016 Stage 1 construction - relocating BMX track, lighting, seating, pathways, irrigation, turf.
September 2015 Council adopt Windsor Siding Reserve master plan
